What is Work Center? (Scheduling, Calculation, Structure)

Last updated on by Editorial Staff
An Overview Work Center

A work center is the specific production resource, a machine, a group of identical machines, or a team of workers, where an operation on a routing is actually performed. It is the unit that manufacturing planning schedules work against and measures capacity in.

The distinction that matters is between a work center and a department. A work center is a capacity grouping. Everything inside it is treated as interchangeable for scheduling, so a job can be loaded onto the work center without naming which machine or operator will run it.

Microsoft’s Dynamics AX 2012 documentation calls its version an operations resource: “one or more people or machines with identical capabilities that are considered as one unit” for capacity planning and detailed scheduling.

Why the definition is worth getting right: capacity is planned, loaded and reported at the work center level. Define your work centers too broadly and the schedule hides real bottlenecks; define them too narrowly and you maintain far more routing data than the plan can use.

What is a work center?

SAP puts it in one line: “Operations are carried out at a work center.” Its documentation says one can stand for machines or machine groups, production lines, assembly work centers, or employees and groups of employees. Oracle describes work centers as “specific production units that consist of people or equipment.”

About the video (checked 28 October 2026): it dates from 2022. Its “three levels” slide (department, planning area, work center) is not a hierarchy that any of the vendor documents in the table below defines. Oracle Fusion, for example, uses plant, then work area, then work center. The rest of the video covers the uses of work center data and scheduling goals in general terms.

A quick test for where to draw the line: if the planner does not care which machine runs the job, those machines belong in one work center. Three identical lathes worked by the same crew can be one work center. A lathe and a paint booth cannot, because they perform different operations and run out of capacity at different times.

Work Center

It is usually defined as being either labor or machine-constrained. While it may contain multiple machines or personnel, they are considered identical in processing products assigned to that center.

It may perform multiple operations, but its available capacity belongs to the work center as a whole, not to each operation. SAP goes one step further and defines available capacity for every capacity category in a work center, such as machine and labor.

Its definitions can be flexible based on process, reporting capabilities, and organization requirements.

What is the function of a work center in production?

A work center is where a routing operation is carried out, and the unit the plan measures capacity against. ERP systems use its data for three jobs: scheduling, because its operating times and formulas give each operation a duration; costing, because it is assigned to a cost center and its standard values carry activity types that price the time; and capacity planning, because its available capacity is compared with the load from orders.

What is the difference between a work center and a routing?

The routing says what is done and in what order: it lists the operations needed to make a product. Each operation names the work center that performs it, and the work center supplies the capacity, the formulas that turn standard values into time, and the cost center. SAP counts work centers, routings and bills of material as its most important production master data. In Odoo the operations are defined on the bill of materials itself, and each one still needs a work center.

Uses of data in the work center

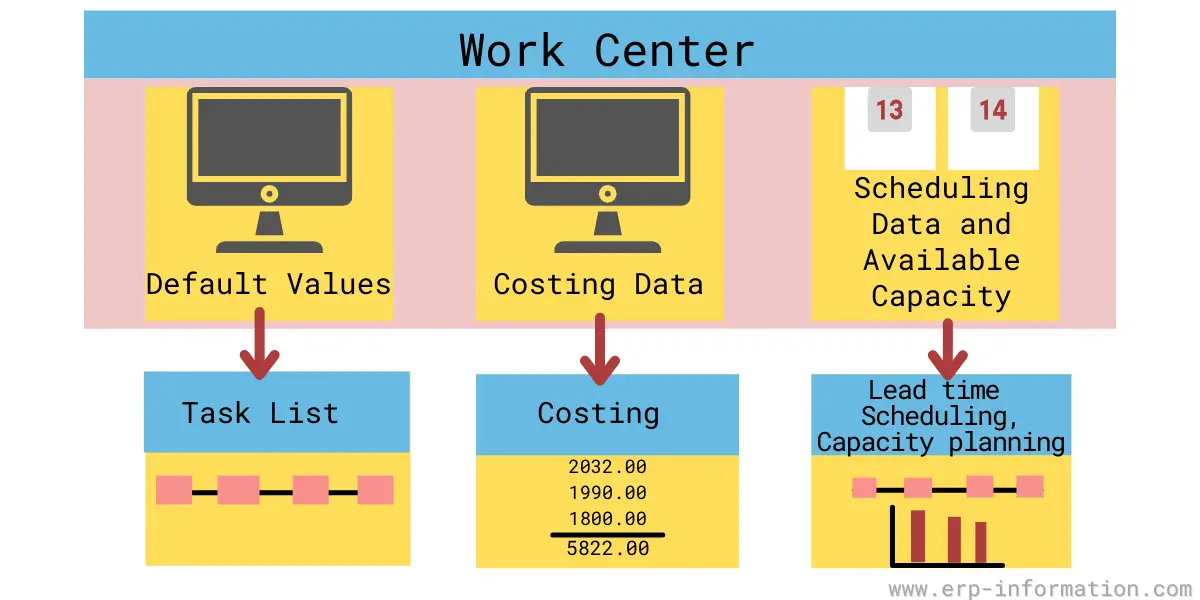

SAP’s documentation lists four uses for the data held in a work center:

  • Scheduling: Formulas entered here help to calculate the duration of an operation.
  • Costing: The formulas here allow you to calculate an operation’s costs, and the work center is assigned to a cost center.
  • Capacity planning: Formulas for calculating capacity requirements and capacity availability are stored here.
  • Faster routing maintenance: default values in the work center are copied into each new routing operation.

Work center scheduling

Work center scheduling decides when each operation runs at its work center. The first question is whether the schedule respects the work center’s capacity at all.

SAP describes the two modes plainly. In lead time scheduling, “the system does not take into account the capacity load of the work centers affected.”

In finite scheduling it checks, for every operation, whether enough capacity remains on the planned date. If there is, it dispatches the operation. If not, “the operation is moved to a date when it can be processed without capacity problems.”

Finite scheduling is worth switching on only where capacity is actually short. SAP sets it per capacity with a Relevant to finite scheduling indicator, and lets you use that indicator to leave out capacities that have enough available capacity, which also improves performance.

Two more settings shape the schedule. SAP lets you keep a queue time in the work center, but uses it only when the routing operation has no queue time of its own.

Dynamics 365 adds a rule for operations that need a machine and people together. Under finite capacity, the resources for the primary and secondary operations must all be free at the same time. The dispatched result is what the shop floor, or a manufacturing execution system, works from.

The following are the main goals of this scheduling.

  • Decreasing lead time
  • Decreasing set-up time
  • Increasing utilization of machine and labor
  • Decreasing work in process inventory
  • Meeting due dates

Work center in SAP

In SAP production planning (SAP PP) the work center is a master data object in its own right, not a report. It is created for a specific plant and then referenced by routing operations, which is what links a product’s process steps to the resource that will perform them. Its work center category, set in Customizing, decides which data can be maintained in it.

Each work center carries the data the rest of the module depends on. It holds the available capacity and the shift calendar behind it, and the formulas used to derive scheduling and costing times from the operation.

It also holds the cost center and activity types that make an operation cost something. Its standard value key fixes which times an operation records, typically setup, machine and labour.

What is the work center in SAP PP?

In SAP PP a work center is plant level master data representing the machine or labour resource that carries out a routing operation. It is not a grouping of business activities, so a step such as processing a customer order is not a work center.

The object holds the available capacity and its shift calendar, the formulas that convert an operation into scheduling and costing time, the cost center and activity types used to cost that time, and the standard value key defining which times the operation records.

A work center may be a single machine, a group of machines treated as interchangeable, or a labour group, and the work assigned to it is loaded against its capacity rather than against a named individual.

Inside one work center, SAP keeps a separate capacity for each capacity category, such as machine and labor. A capacity can also be pooled across work centers. SAP’s S/4HANA training gives the case of five production lines that each need an operator, with only four operators in the pool: “Therefore, only four machines can run at any given time.”

Work centers can also be arranged in a hierarchy. SAP can cumulate available capacity from subordinate work centers up to the work center above them, which is what capacity planning reads at the higher level.

Process manufacturers meet the same object under another name. SAP states that “In PP-PI, resources perform the same function as work centers do in PP”, and warns that Customizing often still says “work center” for both.

Capacity calculation in SAP

Available capacity comes from the work center’s capacity header, not from the routing. SAP defines it as “the product of the number of individual capacities and the productive working time”. The productive working time is called the operating time:

Operating time = (working time − break time) × capacity utilization rate / 100

The utilization rate allows for unplanned interruptions such as technical faults. Here is our calculation with SAP’s formula. The work center runs 10 am to 5 pm with a 1 hour break, at 85 percent utilization, and has 2 identical machines (2 individual capacities):

  1. Working time minus breaks: 7 h − 1 h = 6 h
  2. Operating time per machine: 6 h × 85% = 5.1 h
  3. Available capacity per day: 5.1 h × 2 machines = 10.2 h

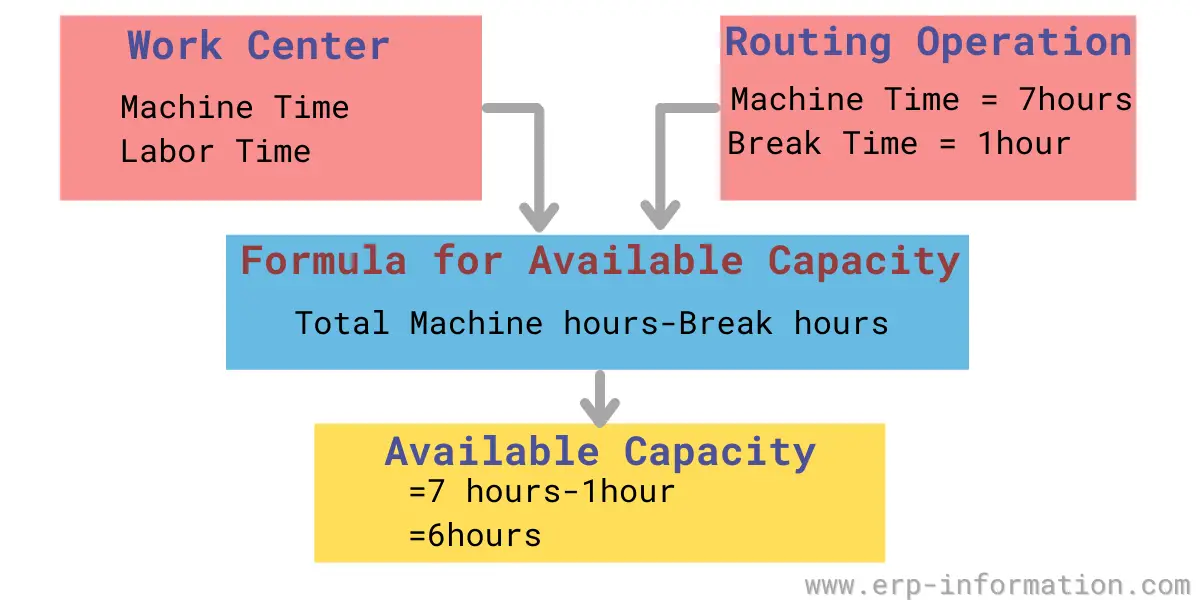

Stopping at working time minus breaks, 6 hours, overstates what one machine delivers and leaves out the second machine entirely.

SAP work center available capacity: 7 hours minus a 1 hour break, times 85 percent utilization, times 2 individual capacities, gives 10.2 hours a day
  • Required capacity: In the SAP work center, required capacity means the time required to produce a specified quantity of product. To calculate the required capacity, SAP considers operation time and capacity formula.

SAP calculates capacity requirements per operation segment: setting up, processing and tearing down. Each segment uses the formula assigned to it, the requirement for the operation is built from the segments, and a segment with no formula adds nothing. Take an operation with these routing values:

  • Labor time 60 mins
  • Machine time = 60 mins
  • The machine set up time = 30 mins
  • Base Quantity = 100
  • Production order quantity = 200

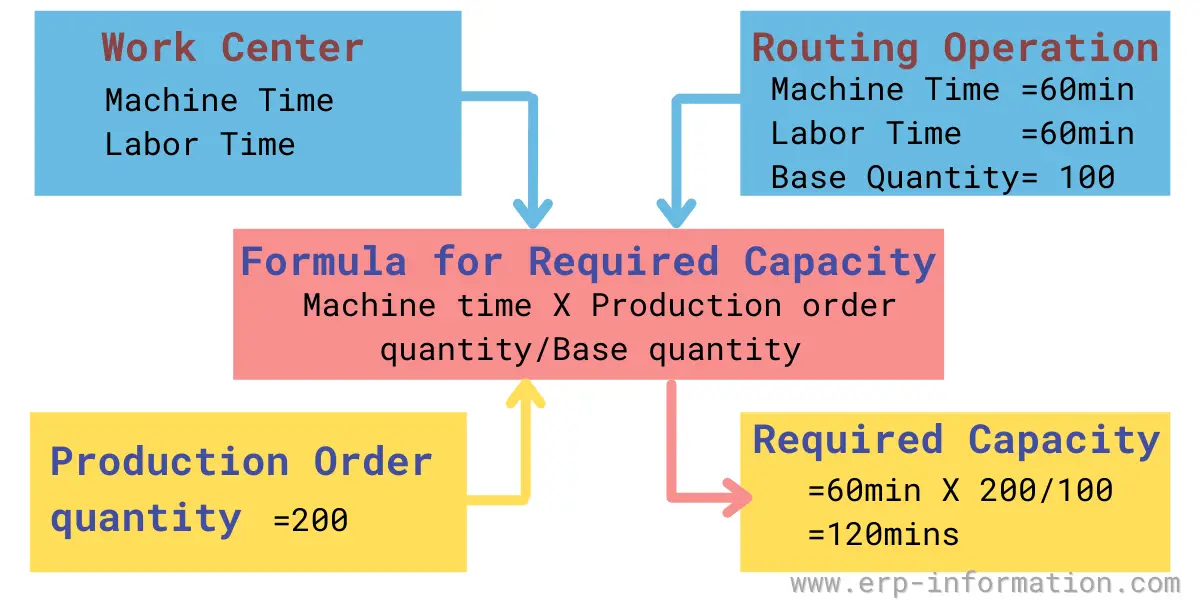

The processing segment, with the usual machine formula:

Required capacity = machine time X production order quantity/base quantity

Required capacity = 60 mins X 200/100

Required capacity = 60 mins X 2

Required capacity = 120 mins.

If the work center also has a setup formula that takes the setup standard value, the 30 minutes of setup is added. That makes 30 + 120 = 150 minutes of machine capacity for the order (our calculation). Without a setup formula, SAP records no setup requirement, and the load looks 20 percent lighter than the machine will actually be.

Evaluate Production Capacity using our Online Production Capacity Calculator

Capacity calculation in SAP work center

Work center capacity: rated versus demonstrated

Available hours are not capacity. A work center that is staffed for 80 hours a week will not deliver 80 hours of good output, because some of that time is lost to changeovers, maintenance, waiting for material and rework. Two standard measures close that gap.

Rated capacity = available hours x utilization x efficiency

  • Utilization is the hours actually worked divided by the hours available. It answers: was the resource running at all?
  • Efficiency is the standard hours earned divided by the hours actually worked. It answers: while it was running, did it produce at the rate the routing assumes?

The two are routinely confused, and confusing them hides the problem. A work center running at 60 percent utilization and 100 percent efficiency has an availability problem. One at 100 percent utilization and 60 percent efficiency has a process or standards problem. The remedies are not the same.

ERP systems store these assumptions in different fields. SAP keeps the utilization rate in the capacity header, as above. Odoo 20 has a Time Efficiency percentage on each work center, and its own example is older equipment that takes twice as long, set to 50 percent. It also has an OEE Target.

Worked example

A work center holds two identical machines, run on one 8 hour shift, 5 days a week.

InputValueWhere it comes from
Machines in the work center2Work center master data
Hours per shift8Shift calendar
Shifts per day1Shift calendar
Days per week5Factory calendar
Available hours per week802 x 8 x 1 x 5
Utilization85%Hours worked divided by hours available
Efficiency95%Standard hours earned divided by hours worked
Rated capacity64.6 standard hours per week80 x 0.85 x 0.95

So the planner should load roughly 64.6 standard hours into this work center per week, not 80. Loading the available figure is one of the most common causes of a schedule that looks feasible and is not.

The alternative is demonstrated capacity, which skips the two ratios and simply averages the standard hours the work center actually produced over recent periods. It needs no estimates, so where you have clean history it is usually the more honest number.

The two are worth comparing: a rated capacity that sits well above demonstrated capacity means the utilization or efficiency assumptions are stale.

These figures are what capacity requirements planning (CRP) compares its calculated load against, one work center at a time, after rough cut capacity planning has already tested the master production schedule against the few resources that usually constrain it.

Work center structure

Every ERP models the work center, but each names it and nests it differently. The table is built from each vendor’s own documentation.

ERPIts name for a work centerHow it is organized
SAP S/4HANA (PP)Work centerBelongs to one plant. Separate capacity per capacity category; work centers can form a hierarchy.
SAP (PP-PI, process industries)ResourceDoes the same job as a PP work center.
Oracle Fusion Cloud ManufacturingWork centerPlant, then work area, then work center, then labor and equipment resources.
Microsoft Dynamics 365 Supply Chain ManagementOperations resource, resource groupA route can name a resource or group, or only the requirements a resource must meet.
Odoo 20Work centerRequired for each operation on a bill of materials; can list alternative work centers.
ERPNextWorkstationOne operation can run at several workstations; working hours and operating costs per workstation.
What each ERP calls a work center, from each vendor’s own documentation, checked 28 October 2026.

Two differences matter in practice. First, “workstation” is not a safe synonym. In ERPNext the Workstation is the place or machine where an operation is performed, so it plays the work center’s role. In Oracle a workstation is a physical location, a machine or workbench, that is part of a work center, an option Oracle added in update 24C.

Second, not every system ties an operation to one fixed work center. SAP and Odoo route each operation to a named work center, and Odoo lets you list alternative work centers for when the first is unavailable.

Microsoft notes that in many systems the resource “must be specified in the route”. Dynamics 365 can instead state the requirements, such as a capability, and let the scheduling engine pick a matching resource.

How to optimize your work center for productivity?

Most of the gain comes from making the work center data honest, then planning against it.

  • Load rated capacity, not available hours. Apply the utilization and efficiency figures, then compare the result with demonstrated capacity.
  • Model a shared constraint once. If several work centers draw on the same crew or tool, a pooled capacity stops the plan promising four operators to five lines.
  • Use finite scheduling where capacity is short. Leave unconstrained capacities out, as SAP’s per-capacity indicator allows.
  • Give the scheduler alternatives. Alternative work centers in Odoo, or requirement-based routes in Dynamics 365, let a job move when its first choice is full.
  • Keep setup visible. If the setup segment has no formula, every order understates the load by its setup time.

What to check in your own system

The practical test of a work center definition is whether the schedule it produces can be executed. If capacity is planned at a level that hides a bottleneck, or loaded at available hours rather than rated capacity, the plan will keep promising dates the floor cannot hit.

Before trusting a capacity plan, open three or four work centers and check these inputs:

  1. Does each work center hold only interchangeable resources, or is a bottleneck machine hidden inside a larger group?
  2. Is the utilization rate, or Odoo’s time efficiency, a measured figure or a default nobody has revisited?
  3. Do setup segments have a formula, so setup time reaches the capacity requirement?
  4. Are shared crews or tools modeled as pooled capacity, so the plan cannot book them twice?

If the plan keeps promising dates the floor cannot hit, these four fields are the cheapest place to start looking.
